Hiệu suất công nghệ khoan kích ngầm định hướng đặt đường ống

Hiệu suất công nghệ khoan kích ngầm định hướng đặt đường ống. Pipe-Jacking Project Performance. Similar Project Performance & Financial Report of CHEC. Dịch vụ thi công khoan ngầm - Minh Phuong Corp.

Hiệu suất công nghệ khoan kích ngầm định hướng đặt đường ống

Pipe-Jacking Project Performance.  Similar Project Performance & Financial Report of CHEC

TABLE OF CONTENTS
1.    Pipe-Jacking Project Performance of CHEC    4
2.    Financial report of CHEC    5

1.    PIPE-JACKING PROJECT PERFORMANCE OF CHEC

-    Lot 3.2 Pipe-jacking Work of Shanghai Combined Sewage Control Project, China
-    Samutprakarn Wastewater Management in Thailand
-    Pipe-jacking Work of Ho Chi Minh City Enviroment Improvement Project, Vietnam
-    D43 – Supply, Lay, Testing and Commissioning of Sewerage Pipeline Kuala Lumpur, Malaysia
-    Attach other pipe-jacking performance

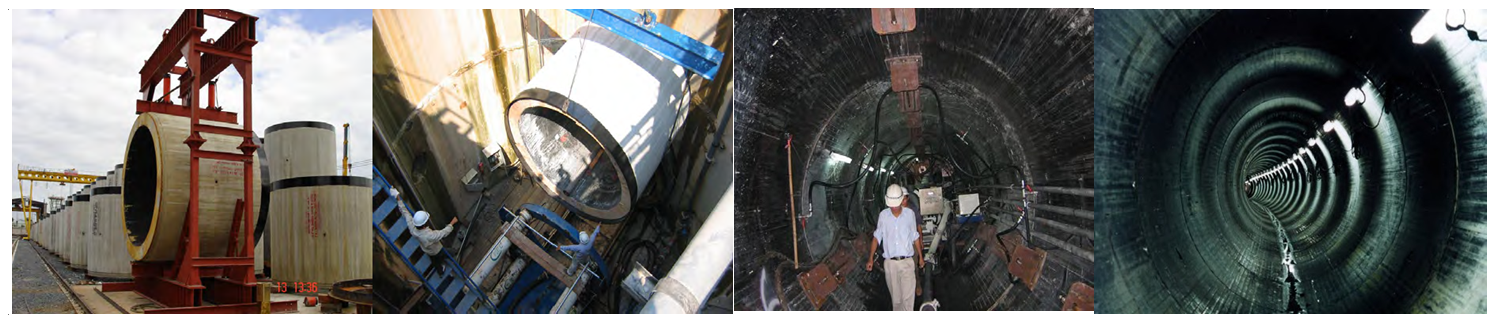

Pipe Jacking Project Performance

Pipe-Jacking Project Performance

-    Lot 3.2 Pipe-jacking Work of Shanghai Combined Sewage Control Project, China

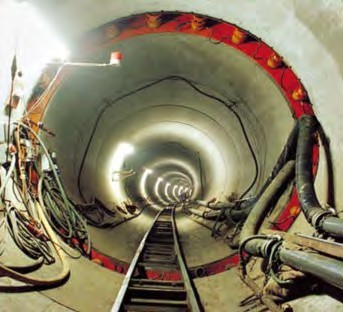

Pipe Jacking

Hiệu suất công nghệ khoan kích ngầm định hướng đặt đường ống

EMPLOYER:Shanghai Combined Sewage Treatment Construction Company
CONTRACTOR:China Harbour Engineering Company Ltd PERIOD:1990.03—1992.04
CONTRACT VALUE:38.58Million CNY

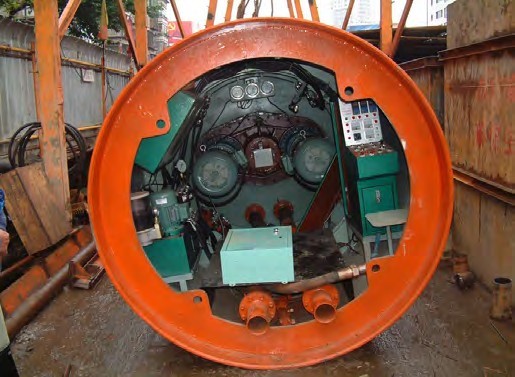

Pipe-jacking Work of Shanghai Combined Sewage Control Project

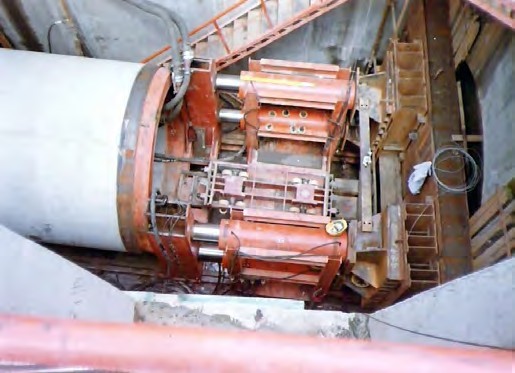

Pipe Jacking Project Performance
Công nghệ khoan kích ngầm định hướng đặt đường ống

- Lot 3.2 Pipe-jacking Work of Shanghai Combined Sewage Control Project, China
Brief Introduction
Three breakthroughs and one series in pipe-jacking technology have been achieved in Lot 3.2 Pipe-jacking Work of Shanghai Combined Sewage Control Project: maximum inside diameter 3,500mm, once pipe-jacking length 1,275m, underground curved jacking available, and forming the pipe-jacking technology for diameter 2000~3500mm pipes.

-    Samutprakarn Wastewater Management in Thailand

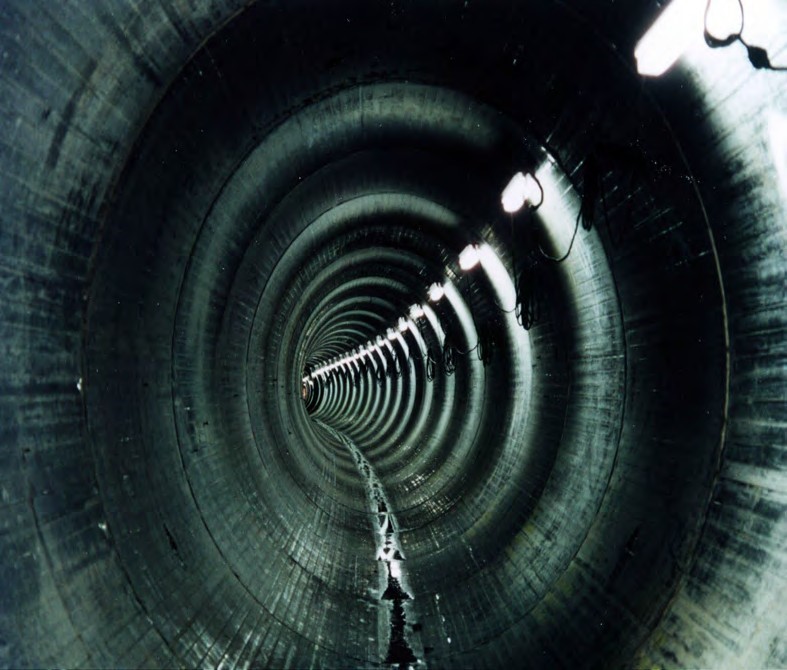

Samutprakarn Wastewater Management in Thailand

EMPLOYER: Pollution Control Department of Thailand CONTRACTOR: NVPSKG & CHEC JV.
PERIOD: 1999.02-2003.08
CONTRACT VALUE: 515 Million Baht

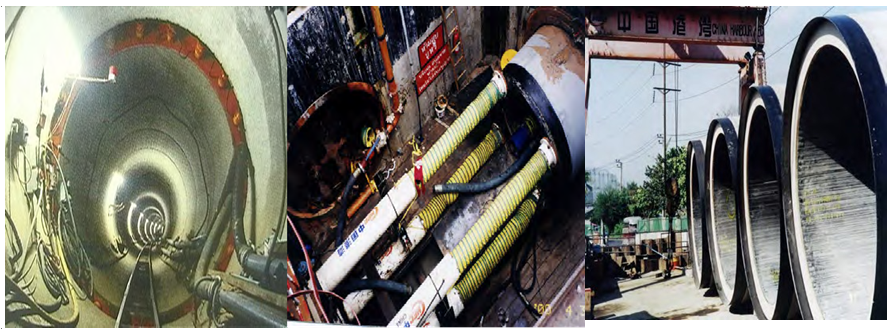

Pollution Control Department of Thailand

Công nghệ khoan kích ngầm định hướng đặt đường ống ngầm

-    Samutprakarn Wastewater Management in Thailand
Brief Introduction
Samutprakarn Wastewater Management Project (SPWWMP) is designed to be able to treat community and industrial wastewater collected from the most densely populated areas of the province. It will be laid by tunneling and pipe jacking under roadways. Wastewater flows generated on the west bank of Chao Praya river will be transfer to the east bank through tunnels under the river and combined the water from the east bank areas. Then the combined flow will be piped to treatment plant.
After the treatment process, treated wastewater will be released through a 3.4- km outfall pipe into the Gulf of Thailand. The CETP will have the capacity to treat up to 525,000 cubic meters of wastewater a day.

Pipe-Jacking Project Performance
-  Pipe-jacking Work of Ho Chi Minh City Enviroment Improvement Project, Vietnam

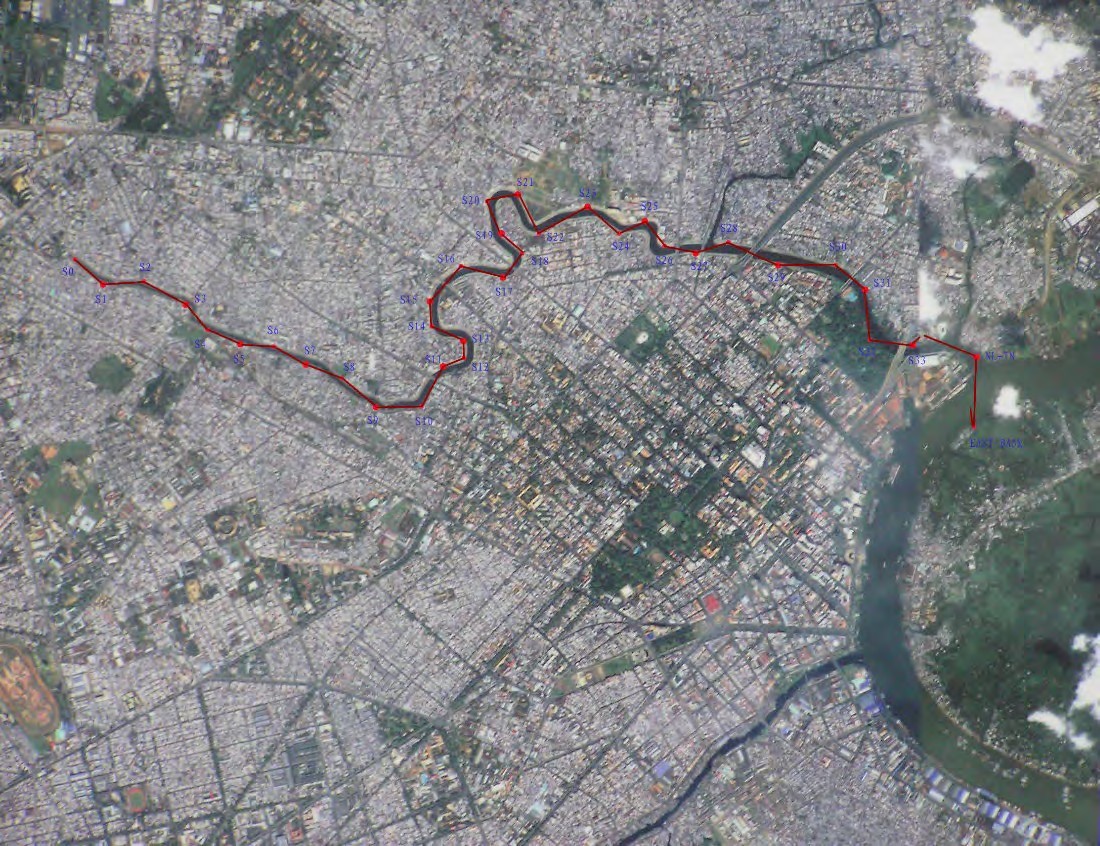

Pipe-jacking Work of Ho Chi Minh City Enviroment Improvement Project

Công nghệ khoan kích ngầm

EMPLOYER: PMU
CONTRACTOR: China Harbour Engineering Company Ltd PERIOD: 2003.10—2006.10
CONTRACT VALUE: 29,200,000 USD (World Bank Finance)
KEY FEATURES: Approximately 11 kilometers long

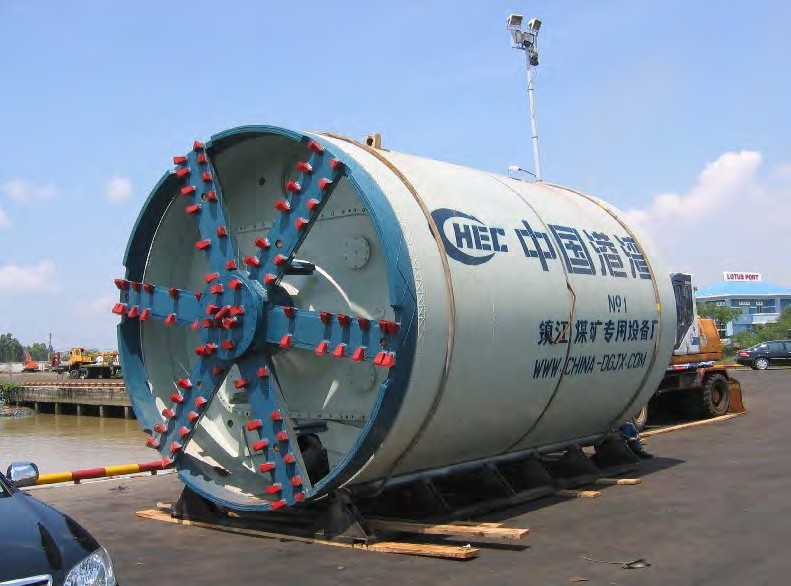

DN3000 TBM

DN3000 TBM

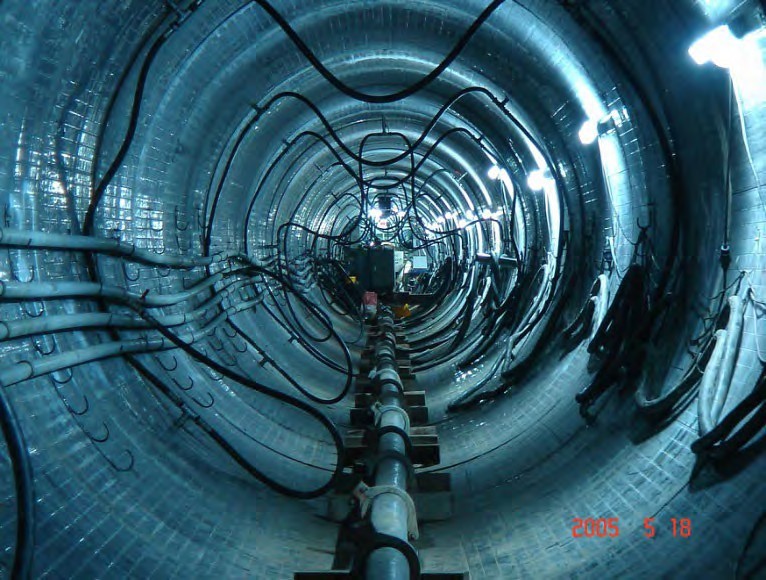

Pipe Jacking

Pipe Jacking

Pipe-Jacking Project Performance
-    Pipe-jacking Work of Ho Chi Minh City Enviroment Improvement Project, Vietnam
Brief Introduction
The work is a canal improvement work of Ho Chi Minh City. It's composed in the fulllength of about 9,100m pull pipes with diameter 3m; 18 operating pits with diameter 9m, depth 22m; 18 accepting pits with diameter 7m, depth 22m; wherein depth of two NLTN pits and east bank pits is about 42m; grooved embedded pipes about 8,016m with pipe diameterranging from 200mm to 2,000mm; as well as 56 overflow wells and 205 manholes.

-    D43 – Supply, Lay, Testing and Commissioning of Sewerage Pipeline Kuala Lumpur, Malaysia

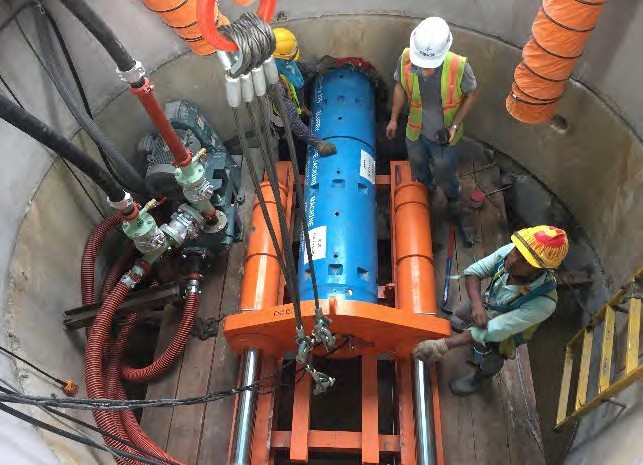

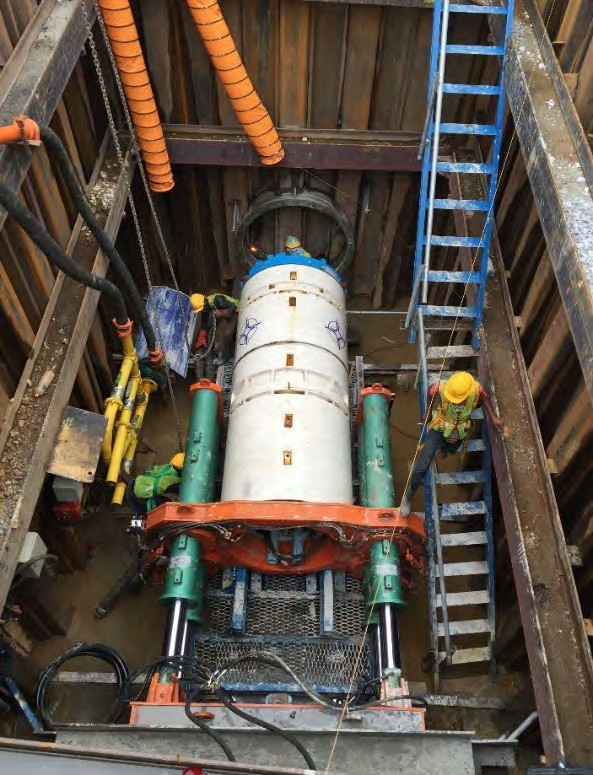

Thi công khoan ngầm

Thi công khoan kích ngầm

EMPLOYER: PMU
CONTRACTOR: China Harbour Engineering Company Ltd. PERIOD: 2014.07—2019.03
CONTRACT VALUE: 107.4 MYR

-    D43 – Supply, Lay, Testing and Commissioning of Sewerage Pipeline Kuala Lumpur, Malaysia
Brief Introduction
The project is located in Kepong District, Kuala Lumpur, and mainly includes the construction of a sewage pipe network with a length of about 21.6 kilometers. The diameter of the gravity gravity pipe jacking pipe in this tender section is 375mm, 450mm, 525mm, 900mm, 1050mm, 1200mm, 1500mm and other diameters.
Notable features:
Mainly for small diameter pipe jacking. It is a difficult point in pipe jacking engineering, especially small-diameter rock pipe jacking.
The first application of the glazed clay pipe jacking, there is no domestic application precedent.
There is no domestic application precedent for the auger pipe jacking construction technology.

-    Attach other pipe-jacking perfprmance

Attach other pipe-jacking perfprmance

See details: Vietnam Vung Ang Power Plant Phase II Pipe Jacking Project

CÔNG TY CP TƯ VẤN ĐẦU TƯ & THIẾT KẾ XÂY DỰNG MINH PHƯƠNG

Địa chỉ: Số 28B Mai Thị Lựu, Phường Đa Kao, Q.1, TPHCM

Hotline:  0903649782 - (028) 3514 6426

Email: nguyenthanhmp156@gmail.com

Tin tức liên quan

6 kỹ thuật khoan ngầm bạn nên biết
6 kỹ thuật khoan ngầm bạn nên biết

1437 Lượt xem

Chúng tôi lắp đặt cáp điện (cho cả truyền tải và phân phối điện), cáp phụ và phụ kiện, viễn thông (bao gồm cả công trình ISP và công trình OSP) và mạng cáp quang cũng như đường ống thoát nước bằng cách áp dụng các phương pháp như phương pháp đào cắt hở; hoặc các phương pháp khoan ngầm, cụ thể là lắp đặt đường hầm cáp, kích ống, khoan định hướng ngang và phương pháp doa khoan có dẫn hướng.

Khoan ngầm có định hướng là gì? Ưu và nhược điểm của công nghệ này?
Khoan ngầm có định hướng là gì? Ưu và nhược điểm của công nghệ này?

1410 Lượt xem

Công nghệ khoan ngầm định hướng ngang thường thích hợp cho các ống thép và đường ống có đường kính nhỏ hơn 1200mm.

Lắp đặt đường ống ngầm dẫn rác thải từ thành phố
Lắp đặt đường ống ngầm dẫn rác thải từ thành phố

1329 Lượt xem

Có nhiều phương pháp lắp đặt đường ống ngầm dẫn rác thải từ thành phố và ghép ống bảo vệ và thường có chất lượng thực hiện rất khác nhau. Ngoài ra, một rãnh lắp phải luôn được đào ngay phía trước bức tường bên ngoài.

Robot khoan qua đường
Robot khoan qua đường

1732 Lượt xem

Robot khoan qua đường

Rủi ro khi đào đường bằng máy khoan ngầm robot
Rủi ro khi đào đường bằng máy khoan ngầm robot

1664 Lượt xem

Trong số các nguy cơ rủi ro khi đào đường bằng máy khoan ngầm robot, bốn nguy cơ nghiêm trọng đã được chọn khi khảo sát tài liệu và xem xét các nghiên cứu điển hình khác nhau về các tai nạn đã xảy ra trên các dự án HDD trước đây.

Dự án thi công khoan ngầm kéo đường ống áp lực bằng cách sử dụng máy khoan HDD đời mới 2021
Dự án thi công khoan ngầm kéo đường ống áp lực bằng cách sử dụng máy khoan HDD đời mới 2021

1662 Lượt xem

Dự án đường ống dài, CCPLP- Dự án thi công khoan ngầm kéo đường ống áp lực bằng cách sử dụng máy khoan HDD đời mới 2021, Dự án phân phối đường ống khí Cái Mép-Phú Mỹ và trạm phân phối khí Phú Mỹ.
